Major modernisation of the Merseyside network
We're delivering a major investment to modernise critical electricity infrastructure in Merseyside, helping to ensure the network remains safe, reliable and resilient for the future.
As part of a £40 million project, we're replacing a key electricity cable connection between Bootle and Kirkby that has been serving homes and businesses across the region since the 1960s. While the existing cable has supported generations of customers, it is now reaching the stage where replacement is needed to maintain the high standards of reliability that communities expect.
The project is being delivered in stages, with work having begun in Knowsley in August 2025. This involves carefully excavating sections of road to replace ageing cables before connecting the new infrastructure to the wider local electricity network.
How long will works go on for?
The overall project will continue until early 2027, with works on and around Rice Lane expected to be completed by November 2026. An indicative programme for this phase of work can be found below.
We recognise that roadworks can be disruptive and may affect day-to-day journeys, routines and access for local residents. That's why minimising inconvenience has been a key consideration throughout our planning process.
By investing now, we're helping to avoid more significant disruption in the future and ensuring that local homes, businesses and community services can continue to benefit from a dependable electricity supply as demand for power increases.
Who are we working with to complete these works?
SP Energy Networks is responsible for delivering the project and is the owner and operator of the local electricity distribution network.
We are working with a north west based delivery partner, Excalon Ltd, who will undertake much of the construction activity on our behalf.
Where are these works taking place?
The cable route runs between our electricity infrastructure in Bootle and Kirkby, passing through electrical substations in Gillmoss and Fazakerley.
Having made good progress up to now, working primarily in industrial locations around the M57 and East Lancashire Road, the work is now coming up to residential areas on and around Rice Lane.
An indicative schedule of specific locations and traffic management arrangements can be viewed below.
How will these works impact on your travel?
Diversion routes and signage will be in place to make people aware, and we will complete the work as safely and quickly as possible to minimise disruption.
We’ll ensure access to properties and businesses is always maintained, and do not expect electricity supplies to be interrupted as a result of this work.
Bus services will continue to operate throughout the works. If a bus stop is affected by traffic management measures, such as a lane closure, a temporary bus stop will be provided nearby in a safe and convenient location outside of the works area.
In some locations, temporary parking restrictions may be required to enable works to be carried out safely. Where this is necessary, advance notice will be provided. Works will also be phased to avoid large sections being cordoned off at any one time, ensuring nearby roads remain available for residents, businesses and visitors.
What’s Next?
From Monday 20 July, you will see our team installing new underground electricity cables along Rice Lane and on Lancaster Street.
This work is taking place for six weeks during the school summer holidays, finishing on Friday 28 August, so that school runs remain on time and uninterrupted,
Our crews will be on site from 07:00 to 17:00, up to seven days a week. This helps us finish each phase as quickly as possible, reducing the time roads are affected.
Following the completion of our work on Rice Lane, we will be moving on to nearby residential streets from late August 2026. This page will remain up to date as the project progresses to keep everyone that needs to know, in the know.

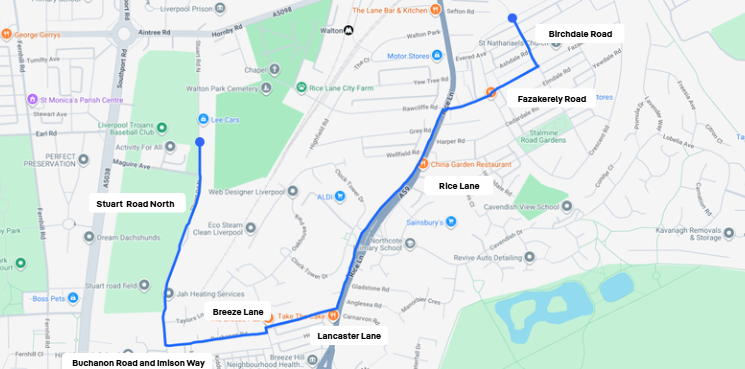

Road | Traffic measures | Start date | End date |
Rice Lane | Temporary traffic lights | Jul 20, 2026 | Aug 28, 2026 |
Lancaster Street | Road Closure (Rice Lane Jcn) | Jul 22, 2026 | Jul 28, 2026 |
Fazakerley Road | Temporary traffic lights | Aug 24, 2026 | Sep 16, 2026 |
Birchdale Road | Temporary Traffic Lights | Sep 6, 2026 | Sep 25, 2026 |
Lancaster Street | Road closure | Sep, 28 2026 | Oct 15, 2026 |
Breeze Lane | Road closure | Oct 12, 2026 | Oct 15, 2026 |
Buchanon Road and Imison Way | Road closure | Oct 12, 2026 | Nov 11, 2026 |
Stuart Road North | Temporary traffic lights | Nov 9, 2026 | Nov 20, 2026 |

Stay up to date
We will keep residents regularly informed as our work progresses, or if any of our plans change.
Contact our community relations team with any questions or queries:
